How can roofing contractors estimate accurate project timelines. Plan phases, handle delays, and satisfy customers to tighten your scheduling.
An accurate roofing project timeline wins bids, protects margins, and keeps customers happy. Most residential roof replacement projects run 1 to 3 days on the roof, but the full project timeline spans 2 to 4 weeks.
This guide shows roofing contractors how to estimate timelines based on several factors that impact every job. You will learn how to scope, schedule, and communicate timelines that hold up in the field. The explanation will go something like this:
An accurate roofing project timeline is one of the strongest sales tools a roofing contractor has. Homeowners compare bids on price, warranty, and the timeline you commit to in writing.
Underestimating timelines damages your reputation and triggers callbacks. Overestimating costs you the bid to the roofing company down the street. The right balance protects margins and earns referrals.

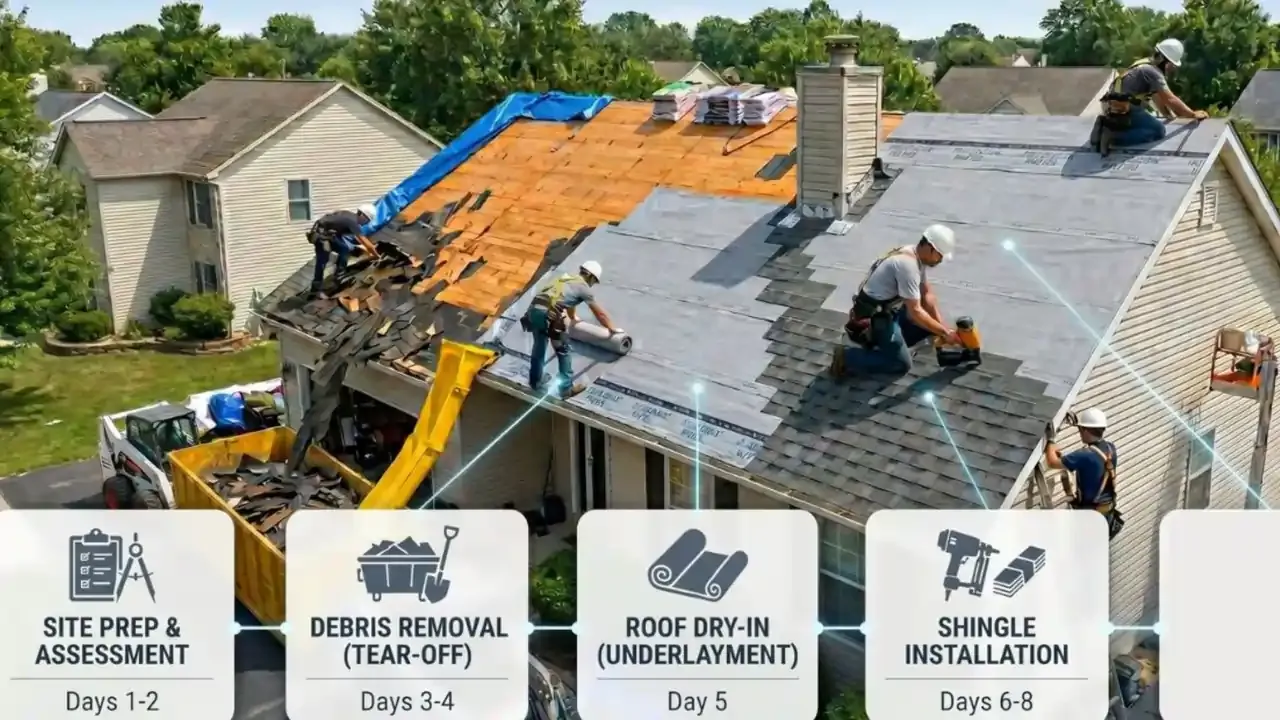

Every roof replacement project follows the same five phases. Understanding the full scope of each phase lets you build a defensible timeline and price the job correctly.
The roofing process typically takes 2 to 4 weeks from first call to final inspection. Most of that time happens before crews ever step on the roof.
The typical timeline scales with roof size, complexity, and roofing material. Use the following ranges as your baseline when building estimates.
A 2026 report from Dr. Roof in Atlanta found that over 85% of standard residential projects finish within 4 days of onsite work. That benchmark assumes experienced crews and clear weather.
| Project Profile | Onsite Install Time | Full Project Timeline |
|---|---|---|
| Small residential roof (under 1,200 sq ft) | 1 day | 2 to 3 weeks |
| Medium residential roof (1,200 to 2,500 sq ft) | 1 to 3 days | 2 to 4 weeks |
| Large or complex residential roof (2,500 sq ft or more) | 3 to 5 days | 3 to 5 weeks |
| Steep pitch with valleys, dormers, skylights | 4 to 7 days | 4 to 6 weeks |
| Small commercial roof | 5 to 10 days | 3 to 6 weeks |
| Large commercial roof | 2 to 4 weeks | 6 to 12 weeks |
The biggest variables are roof complexity, material selection, crew availability, and weather conditions. Hidden structural issues can shift a clean schedule by 1 to 3 days once tear off begins.
Several factors impact the timeline of every roofing project. Build each one into your scope review before you quote a finish date.
Material selection drives both install time and procurement lead time. Build both numbers into the project timeline you give the homeowner.
Asphalt shingle is in stock at most distributors and ships in 1 to 7 days. Specialty roofing material like premium metal panels or tile blends can take 4 weeks or more.
| Roofing Material | Procurement Lead Time | Install Time (Average Home) |
|---|---|---|
| Asphalt shingle | 1 to 7 days | 1 to 3 days |
| Architectural shingle | 3 to 10 days | 2 to 3 days |
| Standing seam metal | 2 to 4 weeks | 3 to 7 days |
| Cedar shake | 2 to 3 weeks | 4 to 6 days |
| Clay or concrete tile | 3 to 6 weeks | 6 to 10 days |
| Slate | 4 to 8 weeks | 7 to 14 days |
Permits and weather conditions cause most schedule slip on roofing projects. Both factors are largely outside the contractor's control. Roofing permit approval ranges from 1 to 10 business days in most US cities. High volume markets can stretch to 6 weeks.
While the process is relatively straightforward in Illinois, other states might have varying timelines. Louisiana now requires a permit and final inspection on every reroof under state laws Act 239 and Act 422, effective August 1, 2025.
According to the National Roofing Contractors Association, weather and permits cause more than 60% of all residential schedule misses. Building these buffers into your bid protects your reputation and your margins.
The free estimate is where every accurate roofing project timeline starts. A rushed inspection produces a bid that breaks down on day one of install.
Document the existing roof in detail. Capture pitch, layer count, decking condition, ventilation, and every penetration that needs flashing. Photograph everything for your file and the customer's contract.
Use a good, better, best estimate format so customers see the timeline tradeoffs of each material. This frame helps them choose without feeling pressured.
Crew size has a direct impact on the timeline of every roofing project. A 5 to 6 person experienced team can finish a 2,000 sq ft asphalt shingle roof in 1 to 2 days.
Sequencing jobs across the season prevents idle crews and missed deadlines. Use roofing project management software to track every job from estimate to closeout.
Customer communication is what separates the smooth project from the frustrated callback. Set expectations once, then confirm them at every checkpoint.
Roofing contractors who automate communication eliminate the most common schedule killer: confusion. Customers who know the plan stay calm when small surprises pop up.
The roofing experts at RoofSnap report that contractors who run these checkpoints cut schedule disputes by more than 50%. Clear communication is the cheapest insurance policy in the business.
Cleanup and final inspection close out the roof replacement experience. This phase usually takes a few hours but may extend into a second day on larger projects.
Clean job sites drive referrals more than almost any other factor. Treat every closeout as a sales touchpoint that drives your next referral.
A typical timeline for a residential roofing project runs 2 to 4 weeks from first contact to final inspection. The actual install on the roof takes 1 to 3 days for an asphalt shingle job on a 1,500 to 2,500 sq ft home. Specialty roofing material can extend the full project timeline to 6 weeks or more.
Build a 1 to 2 week buffer into every roof replacement timeline during spring and fall. Add another week for projects in jurisdictions with permit backlogs. The National Roofing Contractors Association attributes more than 60% of schedule misses to weather and permits.
Quote 1 to 3 days for an asphalt shingle roof on a 1,500 to 2,500 sq ft home with a 5 to 6 person crew. Add 1 day for steep pitch (8/12 or higher) or complex valleys. Add 1 to 3 days for discovered decking repairs.
Document the discovered damage with photos and deliver a written change order before any extra work begins. Most roof deck repairs add 1 to 3 days depending on severity. Build this contingency language into your contract so customers expect it on the front end.
Permits add 1 to 10 business days in most US cities and up to 6 weeks in busy markets. Track permit turnaround time by jurisdiction inside your project management software. Pull permits the same day the contract is signed to compress the overall timeline.
Use a good, better, best format with timeline tradeoffs for each option. Show the homeowner why an in stock asphalt shingle finishes 2 weeks faster than a custom metal roof. Realistic timelines win more bids than aggressive ones once customers compare three estimates side by side.
A commercial roof replacement runs 1 to 4 weeks of install plus phased material delivery, safety planning, and tenant coordination. Small commercial buildings finish in 3 to 6 weeks total. Schools, apartments, and retail centers often require night or weekend work to limit business disruption.
Roofing platforms like AccuLynx, RoofSnap, and JobNimbus connect estimates, contracts, scheduling, and payments in one ecosystem. The right roofing project management software cuts callbacks, automates customer updates, and protects margin per job. Most platforms offer a free trial so you can test fit before committing.
Determining a roofing project timeline comes down to disciplined scoping, accurate material lead times, and honest customer communication. Most residential jobs run 1 to 3 days on the roof and 2 to 4 weeks end to end. Roof size, material selection, permits, and weather are the factors that impact the timeline most.
Tighten up your roof replacement process with the framework above and your bids will close at higher rates. Pair the workflow with quality project management software, and treat closeout as a referral opportunity. But before all of that, you need an actual roofing license.
